Calculating Welding Costs and Times
Calculating welding costs and times are important because welding
can be a significant part of the costs in fabricating welded structures and
components. Knowing how to estimate the volume of weld to be deposited, and the
typical time it will take to perform the welding is important to prepare
quotations and also to plan schedules.
The WelderDestiny Compass: Weekly e-zine Subscription
You can take a look at "The WelderDestiny Compass" back-issues by clicking here.
Welding With the Gas Tungsten Arc Welding (GTAW) Process: GTAW is typically a low deposition rate process.
There
are many resources available that approach the issues associated with calculating welding costs from different perspectives,
so it is important to note that there are a number of ways to get to an answer.
The approach taken in this web page is a relatively fundamental approach that
should be easily modified for use in most instances. The steps taken to calculating welding costs and times are as follows:
- Calculate
the volume of weld metal to be deposited. This is essentially based on the weld
preparation and the length of weld.
- Calculate
the mass of weld metal that needs to be deposited, based on the density of the
particular material that you are working with.
- Apply
a “recovery factor” to the weld mass calculated, to estimate the total amount
of welding consumable needed. (Some of the consumable will be wasted and will
not end up in the joint. For instance, in the case of Shielded Metal Arc
Welding (SMAW) there will be stub losses, slag losses and spatter losses.)
- Based
on the mass of welding consumable needed, you will now be able to find out the
cost of the welding filler metals by getting an appropriate quote from your
filler metal supplier. This does not account for “supplementary” consumables
such as shielding gas or grinding discs etc. You will need to calculate those
costs separately, based on the type of job it is that you will be doing.
- Calculate
the time it would take to deposit the necessary mass of weld metal, based on a
deposition rate for the particular welding process that you will be using. This
value assumes a 100% “arc on” time.
- Apply
an “arc on factor” to take account of the fact that no welder ever welds 100%
of the time. There will be times when s/he needs to remove a stub and replace
with another electrode, or perform some grinding or other cleaning between weld
runs etc. Obviously this factor will be different for each welder, but you can
start with a typical industry accepted value, and refine this for your
particular business or project. (Your business may be more or less efficient
than the industry average, or the particular job may be more difficult,
resulting in a lower arc on percentage. This is often the case for maintenance
type work)
- This
will now tell you how many “man hours” it will take to complete the job.
- Based
on the man hours, you can then estimate the length of time it will take to
complete the job, by deciding how many welders will be welding at the same
time.
- Based
on the man hour calculation, and the assumption you have made of the number of
welders welding at the same time, you can estimate how many welders you need,
and for how long. When calculating your manpower costs at this point, do not
forget to add in an allowance for assistants, and also “unproductive time”
associated with your company’s systems and processes. (Think safety meetings,
morning meetings, quality circles, safety inspections or other administrative
processes.)
-
Each
business will also have some “overhead cost” allowance based on the total time
the job will take. This takes account of the cost of management, quality
control personnel, equipment, indirect consumables etc. These overhead costs
will be different for each company, and will also vary widely between different
industries. Sometimes the estimator just uses a factor based on the costs
calculated above (e.g. Multiply costs calculated by 1.5 to account for
overheads.) and sometimes it will be an “overhead rate” based on the number of
welding man hours. (e.g. $50 per man hour overhead cost.)
Please keep in mind that this discussion on calculating welding costs is only looking at the welding operation. It does not take account
of costs associated with materials or boiler making / construction activities.
Welding Pipeline Double Joints With Submerged Arc Welding: SAW is typically a high deposition rate process.
Estimating Packages For Calculating Welding Costs
Calculating welding costs and times would obviously be rather time consuming if we have to re-calculate the basics for every
estimate you need to do, so most businesses will have some kind of automated
estimating system. There are a number of generalized commercial estimating
packages available, that can be used for almost any type of work. The
shortcoming of most of these generalized estimating systems is that the
methodology for calculating welding costs and times are not not included in enough detail. In this situation, calculating welding times and costs are typically included in more specialized estimating
applications that focus on the welding operation.
Many
businesses therefore have a combination of commercial estimating packages,
combined with a selection of spreadsheets to provide some inputs to the
commercial estimating package. Obviously, some businesses just use a selection
of spreadsheets to do their estimates, which would include calculating welding costs and times. This is especially the case for smaller
businesses.
Help With Calculating Welding Costs and Times
To
help you with the calculating welding costs and times, we have made available a spreadsheet
that does the welding volume and time based calculations. You can download the spreadsheet by clicking here. While I have been careful to make a spreadsheet that makes reasonably accurate calculations, WelderDestiny does not take any responsibility for the answers you get from this spreadsheet. Please use at own risk.
To
help get you on your way, below are some explanations on how to use the
spreadsheet for calculating welding costs and times. The spreadsheet contains two worksheets.
The first worksheet deals with bevel, butt and fillet welds. The second deals
with TYK joints. The TYK joints are addressed separately because they are a lot
more complicated to calculate the weld volume.
Guidelines for calculating welding costs and times for the “Bevel Butt Fillet”
worksheet:
- In
the “Bevel Butt Fillet” worksheet, the weld details are captured on the top
left hand side.
- In
the first column there are 5 different types of weld preparations described.
(Each weld preparation has been replicated 4 times, to allow you to enter more
than one of each type if needed.) This is highlighted in yellow.
- The
next 5 columns deal with the different dimensions associated with the different
weld preparations. This is where you enter the raw dimensional data for the
calculations. These columns have been highlighted in light blue. To exclude any
row from the calculations, ensure that the value in the “Length” column is
zero. (Currently, typical values have been entered, just to offer some
guidance.) Please take note of the units used for the different dimensions.
This worksheet has been completed in SI units. If there is enough demand, I
will reproduce this in Imperial units, although it would be quite easy for you
to make those modifications yourself.
- The
next 4 columns are the outputs of the calculations. (Please note that if you
change anything in these columns, then the calculations will be affected, so be
careful.) The calculations here take into account the dimensional data, along
with the filler metal and welding details further down on the left hand side of
the worksheet. These columns have been highlighted in light green.
- Sketches
showing the different weld preparations and the associated dimensions are also
included just to the right and below the calculation table.
- The
filler metal details are entered in the light blue highlighted cells on the
left hand side below the calculation table.
- The
welding details are entered in the light blue highlighted cells below the
filler details.
- Below
the welding details is a list of terms used in the worksheet.
- To
the bottom right of the worksheet, in line with the filler details are some
typical values that can be used for different welding processes and materials.
Just above this are a couple of “quick calculators” for converting pounds per
hour to kilogram per hour and inches to millimeters.
- To
the bottom of the worksheet there are a lot of reference materials to help make
decisions regarding deposition rates and efficiencies. Please take care of the
units, as some of the references are in Imperial units and some in SI units.
You can use the “quick calculators” to make any unit conversions required,
before entering the values into the worksheet.
-
The
results from the worksheet calculations are summarized in the “Total” row that
has been displayed in a bold red font. The total filler requirement, including
the allowance for weld metal recovery percentage is given in the “Total Filler
Required” cell.

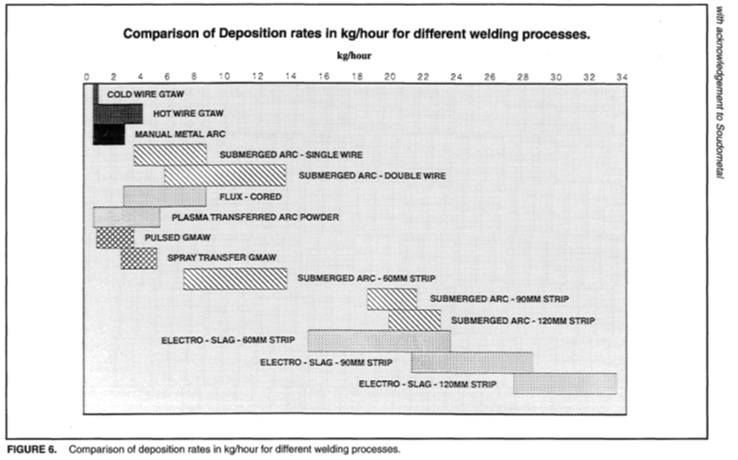

Typical Deposition Rates That Can Be Expected With The Different Welding Processes.
Please
note that the dimensional details entered in the worksheet will be subjected to
values entered in the filler details and the welding details to obtain the
necessary calculations. This means that you can only deal with a single filler
metal and a single welding process at a time. This does complicate calculating welding costs and times for multi process welds, but it can still
be done as follows:
- First
apply the dimensional and welding data as though you were only welding the root
process. For example, if the root process was going to be a 1000mm long, 4mm
thick Gas Tungsten Arc Welding (GTAW) deposit on a 20mm thick plate using a 60°
included angle single Vee weld with a 4mm root gap, then you will enter: a =
30; b = 2; T = 4; h = 0; Length = 1. (Make sure that you enter the necessary
GTAW values in the filler details and welding details sections.)
- Next,
apply the dimensional and welding details as though you were only welding the
filler and cap process. If we are going to weld the rest of the joint described
in the point above with the Flux Cored Arc Welding (FCAW) process, then we will
enter the following information for the FCAW section: a = 30; b = 5; (This is
an approximation of what the “root gap” would be if we removed the GTAW
section.) T = 16; (20mm plate thickness minus the 4mm for the root process.) h
= 3mm; (An approximation of how high the cap reinforcement will be.) Length = 1
(Make sure that you enter the necessary FCAW values in the filler details and
welding details sections.)
-
The
filler metal and man hour values calculated from the two points above can then
be used appropriately to perform the rest of the cost and time estimate
calculations.
The
guidelines for calculating welding costs and times for the “TYK Joints” worksheet are as follows:
- This
worksheet is geared to “T” and “Y” joints between two pipe sections
intersecting in a single plane. Out of plane pipe intersections, and “K” joints
that intersect at the node would require some modifications to get accurate
answers, although the answers will not be too far off.
- On
the top left hand side of the worksheet, we have the main dimensional information.
This is largely based on the diameter of the smaller member, and the angle that
the smaller member makes with the main member.
- The
light blue cells are where you need to enter the necessary information.
- The
light green cells show you calculated information. As a general rule you do not
want to mess around with the green cells.
- Below
the dimensional information on the top left hand side is where the filler
information is entered. (In the light blue cells.)
- For
the TYK Joints worksheet you need to enter the information for the root and the
“main” welding processes. This allows you to do the entire calculation in one
go, when you have different processes for the root and filler / cap. If you
only have one process, then enter a root thickness of 0mm.
- Below
the filler and welding process details sections on the worksheet, is the “TYK
Joint Weld Detail Information” input section. This is a matrix that further
defines the weld preparation details for the different parts of the weld.
- Only
enter the relevant dimensional information in the cells that have been
highlighted in light blue. The cells highlighted in light green are calculated
values, so do not mess with those cells.
- To
assist in choosing which of the different weld details are appropriate, there are
four sketches included on the right hand side of the worksheet. (Detail 36;
Detail 37; Detail 38; Detail 39)
- You
need to select one “Toe of Weld” row, one “Sides of Weld” row and one “Heel of
Weld” row to use in the calculations. You select this by placing a 1 (Yes) or 0
(No) in the relevant cell of column “G” of the weld detail matrix. Be guided by
the descriptions in column A and the angles given in column B. (Note that this
is based on the details given in AWS D1.1, but you need to select the most appropriate
weld details.
- Please
disregard the grey highlighted block on the bottom right hand side of the
worksheet. This is used for embedded calculations. If you mess with these
cells, you will get wrong answers.
- The
calculated filler metal quantities and man hours are specified below the weld
detail information, and is highlighted in pink.
-
Please
read the “Notes” section on the bottom left hand side of the worksheet for
further guidance on the use of the worksheet.
By
using the worksheets supplied, you should be able to get the necessary welding
consumable and welding man hour values required to perform the higher level
costing estimates for your welding job.
The WelderDestiny Compass: Weekly e-zine Subscription
You can take a look at "The WelderDestiny Compass" back-issues by clicking here.
